Contract Lifecycle Management Best Practices



contract-lifecycle-management-best-practices-approval-routing

Practices the lifecycle stages already imply

Most of what counts as good practice here is already latent in the stages themselves. IBM sets out the process as a step-by-step sequence, generally including seven stages, while noting the number varies by organization. The first stage is the one that decides what the rest can show: IBM says contract request and initiation begins the audit trail of the contract, typically using a standardized intake form to help ensure continuity and collect all necessary data. A trail that starts at signature cannot show how the terms were arrived at.

One practice for each stage after the request

Six stages follow the request in IBM's own sequence. Each card names the practice that that stage's description points at.

Authoring

IBM says legal and procurement teams typically draft contracts, using pre-approved, standardized templates and automated clause libraries. Making the library the default matters because drafting from the last similar contract propagates whatever was wrong with it.

Negotiation

IBM describes revisions and redlining to address concerns, edits and required changes to the terms, and notes AI-assisted redline tracking can flag deviations from standard terms. Track deviations as they happen.

Review and approval

IBM's automated approval process routes documents in real time to the appropriate departments for final approval, and it places the parties' own review before that routing begins. The practice is to separate reviewing the terms from approving them.

Signing

IBM notes the software can include e-signature capabilities allowing parties to sign digitally across jurisdictions, subject to applicable laws. The practice is to treat the jurisdiction question as a precondition.

Compliance monitoring

IBM's post-signature stage tracks performance metrics, specific milestones, obligation management, risk scores, compliance risks and regulatory compliance requirements, and it calls this the stage at which to make adjustments if necessary.

Renewal

IBM notes renewal workflows often use AI to track deadlines and flag upcoming auto-renewals or termination dates, and says these tools can surface contract performance trends. Decide renewals on recorded performance rather than on inertia.

The five factors IBM compares, and four to act on

IBM compares manual and automated management across five factors. The fifth, scalability, is the one a pilot cannot test; the four below can be measured on a real portfolio.

Speed

Manual work needs someone to remember to act.

Error rate

Version control issues and manual data entry raise it.

Visibility

Manual status is limited to whoever holds the thread.

Compliance tracking

Reactive, often caught only during an audit.

Six moves to put an existing portfolio under management

The stages describe a single contract. Putting an existing portfolio under management takes six moves, in this order.

Standardise the intake:

One request form, so every contract starts the same way.

Build the clause library:

Pre-approve the language before anyone drafts again.

Centralise the repository:

One searchable location for every contract and attachment.

Encode the routing:

Rules by value, risk or contract type, not by memory.

Instrument the obligations:

Track milestones and dates against each signed contract.

Set the renewal alerts:

Flag auto-renewals and termination dates before they pass.

Where the value actually leaks

  • The WorldCC report cited by IBM attributes that 11 percent to causes including poor negotiation, unrecorded changes and poorly planned renewals, each accounting for 2 to 3 percent of losses.
  • An average 11 percent of a contract's value is lost after signature, in the same World Commerce and Contracting report as cited by IBM.
  • IBM describes manual management as relying on spreadsheets, email threads and shared folders, which works for a few agreements but breaks down as volume grows.
  • Without a managed lifecycle, IBM says organizations risk missed renewals, compliance issues, revenue leakage and slower deal cycles.

Four practices that change what the others can achieve

Four practices worth separating from the stage-by-stage list, because each one changes what the other practices are able to achieve.

Start the audit trail at the request, not at the signature

IBM puts request and initiation first and says the stage begins the audit trail, typically using a standardized intake form to help ensure continuity and collect all necessary data. Everything downstream inherits the completeness of that record, and no later stage can reconstruct it.

Treat the signature as a midpoint rather than an end

IBM places compliance and risk monitoring after signing, covering performance metrics, specific milestones, obligation management, risk scores, compliance risks and regulatory compliance requirements. The WorldCC figure IBM cites, an average 11 percent of contract value, is a post-signature loss.

Put the clause library upstream of the drafters

IBM's authoring stage has legal and procurement working from pre-approved, standardized templates and automated clause libraries. A library that exists but is not the default is a reference document, and the deviations it was meant to prevent still reach the counterparty.

Make renewals a decision rather than an event

IBM describes renewal workflows tracking deadlines, flagging upcoming auto-renewals or termination dates, and able to surface contract performance trends. Poorly planned renewals are among the causes the research IBM cites names, each accounting for 2 to 3 percent of losses.

Who has to adopt the practice for it to hold

IBM names four teams that typically manage the process, and lists working from one version of a contract among the benefits. Three of the four appear below.

  • Legal teams standardize contract creation, reduce risk, and maintain a centralized, auditable repository.
  • Procurement teams streamline vendor onboarding, automate purchase agreements and manage contract renewals proactively.
  • Sales teams accelerate deal approvals for pricing exceptions, custom terms and contract modifications.

Those pages describe what each group does with altaFlow rather than how a lifecycle should be run.

The practitioners named in altaFlow's own records

Mandy Hoffman Business Operations Manager

Hoffman is a named speaker for T2 Biosystems, and her account is about the audit consequence of a managed process: 'Compliance audits, which once took weeks, are now completed in just days.' The story page publishes no time-saving figure.

Sam Ginzberg Chief Information Officer

Ginzberg is the named speaker for Royal Care, whose card spans onboarding to incident reporting. As published before the rebrand: 'There is no need for dual entry; WorkFlow eliminated the risk of errors.'

Two records of a document process brought under control

Both accounts come from altaFlow's published customer records and stay inside what those records state.

Compliant forms at T2 Biosystems

T2 Biosystems handled sensitive medical data through MS Word and Adobe Acrobat, with a rigid compliance process and an inconsistent end-user experience

  • T2 Biosystems configured a no-code workflow to match their own process
  • Completed compliant documents attach back to Salesforce records

Resulting in save-and-return functionality for end users and, per Hoffman's testimonial, compliance audits moving from weeks to days, while the story page itself states the time savings were immediate without publishing any figure

HR paperwork at Royal Care

Royal Care ran HR paperwork and signature gathering through printing, mailing and retyping, with dual entry carrying a risk of errors

  • Royal Care streamlined the HR processes on altaFlow's no-code platform
  • The flows span onboarding through incident reporting

Resulting in the elimination of dual entry, on the card's own account, on a card that spans HR workflows from onboarding through incident reporting and that publishes no figure of any kind alongside it

Governance obligations the lifecycle sits under

  • Audit trails: IBM notes automation can provide an audit trail
  • Retention limits: GDPR sets a storage limitation principle
  • HIPAA Security Rule: Administrative, physical and technical safeguards for ePHI
  • SOC 2: An AICPA examination of a service organization's controls
  • Processing scope: GDPR covers automated and manual processing alike
  • Card-data handling: altaFlow routes transactions through third-party PCI DSS processors

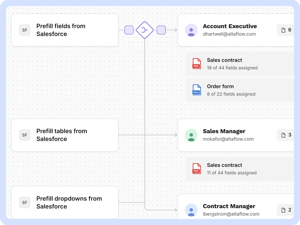

How the contract itself moves on altaFlow

altaFlow describes its own document loop in four moves. These are altaFlow's platform claims, not stages of the lifecycle as IBM defines it.

Data leaves the record:

altaFlow pulls from Salesforce or captures a web form.

One pass builds the document:

Conditional logic and dynamic tables assemble the correct version.

A governed workflow routes it:

Approval and signature, every step tracked.

The result writes back:

Into the system of record, with no re-typing.

FAQs about contract lifecycle management best practices

Six questions that come up once a team tries to turn the stages into something people actually follow.

Which practice should we adopt first?

Standardised intake is the strongest candidate, on this reading rather than on IBM's. IBM places request and initiation first in the sequence and says that stage begins the audit trail of the contract; every practice after it works on a record whose completeness it fixed.

How many stages should our process have?

IBM says the number varies by organization, and generally includes seven. The count matters less than the arc: request, authoring, negotiation, review and approval, signing, compliance and risk monitoring, then renewal. Sources differ on how the post-signature work is divided.

What does the research say we are losing?

A World Commerce and Contracting report, as cited by IBM, found organizations lose an average of 11 percent of a contract's value after signature. The same research attributes losses to causes including poor negotiation, unrecorded changes and poorly planned renewals, each at 2 to 3 percent of losses.

Is a centralised repository really necessary?

IBM lists a single, searchable location for every contract and its associated documents among the features of modern platforms, and describes manual management as spreadsheets, email threads and shared folders that break down as volume grows. Visibility is the factor it names.

How do we stop deviations reaching the counterparty?

Two practices together. IBM's authoring stage uses pre-approved templates and automated clause libraries, and its negotiation stage notes AI-assisted redline tracking can flag any deviations from standard contract terms as changes are made.

Does any of this apply to a small contract volume?

IBM's own framing suggests less of it does. It says manual management works for a few agreements but breaks down as contract volume grows, and that the process is especially useful for businesses managing high contract volume.
